GIVING TOTAL

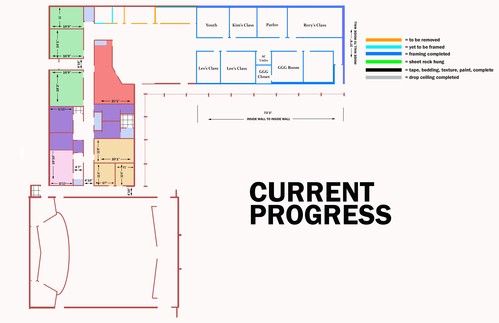

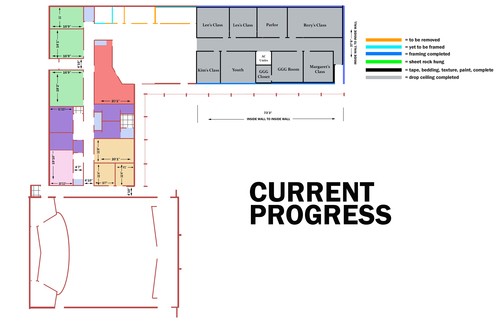

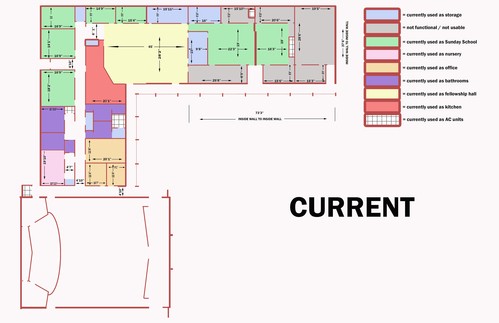

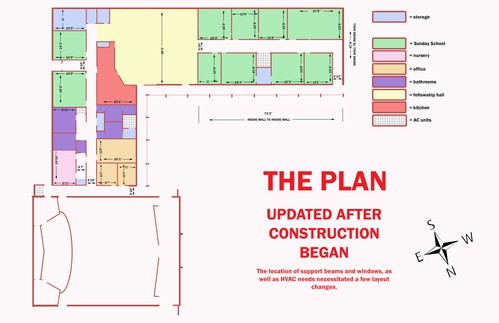

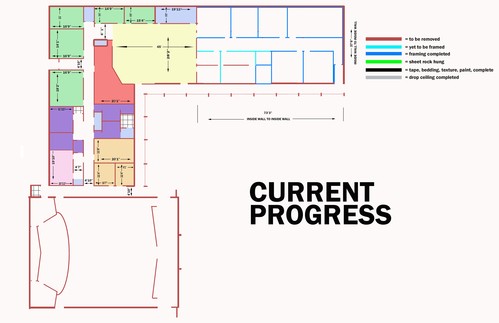

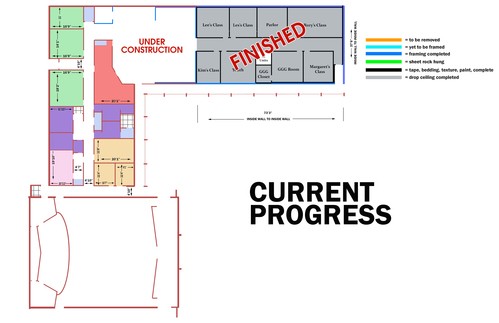

CONSTRUCTION PROGRESS

NEXT STEPS

We are thankful for the men and women of our church who possess special talents and skills for projects such as this.  Below is a list for any eager volunteers outlining the tasks that need to be done.  While some tasks can be done at various times, IT IS IMPORTANT THAT THESE TASKS ARE DONE IN THIS ORDER.  As we check off certain parts of the list, we'll scratch them off the list!  What a blessing to have such able and willing volunteers!  If you want to help, but want some more clarification on what needs to be done, please contact Rory or Leo.

  • DEMO EXISTING SUNDAY SCHOOL WING:
    • Tear out drop ceiling
    • Take up carpet and tile
    • Tear out existing plaster and sheet rock
    • Tear out all walls running north to south (leave east to west walls)
    • Haul off debris

  • CLEAN UP CURRENT ELECTRICAL
    • Identify and label the current electrical boxes in the ceiling.
    • Remove all down-hanging plugs and switches.
    • Wire up temporary lighting for ongoing construction.
    • Remove remaining ceiling grid and light fixtures.

  • FRAMING
    • Frame up two long (east to west) walls (potential load bearing).
    • Remove old east to west walls.
    • Frame up the remaining walls (north/south)
    • Frame in the exterior cubby hole with exterior door and weatherproof it.
    • Remove current exterior doors in cubby hole.  Frame for interior closet doors.
    • Build new jams for older and currently removed interior doors to be reused.

  • ELECTRICAL
    • Install HVAC
    • Install electrical.
    • Install any other wiring deemed necessary (AUDIO, SDI, HDMI, CAT-5 INTERNET, etc.)

  • FINISH WALLS
    • Install insulation in walls.
    • Hang sheetrock
    • Tape, bed, and texture.
    • Paint walls

  • DOORS AND CEILINGS
    • Install interior doors
    • Install drop ceiling and ceiling insulation in classrooms (not yet in hallway)
    • Install drop ceiling lights and HVAC vents

END OF PHASE 1 - BEGIN PHASE 2 WITH DEMO OF FELLOWSHIP HALL.

COST ANALYSIS

DEMOLITION COSTS - $1,420.00
Will need it on two separate occasions.

CAPROCK WASTE
$300 delivery fee
$671 per haul
$52 per ton of disposal
30 day rental period
Initial cost - $1,306.01
Over 10 tons = overweight fee of $300

HAPPY CONSTRUCTION:
20 day rental period
$45 / ton charge over 4 tons
With tax exemption - $1,365.00
No penalty after 10 tons

AR Disposal LLC
1 Month Dumpster rental$350.00
$45 per ton (8 tons)$360.00

FRAMING COSTS - $9,378.67
2x4x10 (530)$2,814.30
2x4x16 (110)$932.80
Framing Nails$129.00
R-13 bat insulation (38bags)$2,594.64
4x8x1/2 sheetrock (223)$2,004.77
sheet rock screws$199.92
Joint Tape (12 rolls)$150.24
Joint compound (112.5 gal)$474.00
Outside Delivery$79.00

ELECTICAL COSTS - $5,465.00
64 Light Fixtures (2x4 LED troffers)$4,800.00
12-2 Romex (500ft)$380.00
Plugs (50) & Switches (10)$285.00
HVAC COSTS - $25,000.00
LOUIS DRUM BID$34,350.00
2 - 4 ton systems hung in attic
All duct work
Gas and Vents
Return air in each room
No electrical

PHIL KERR BID$25,000.00
Phil has agreed to do everything at cost
He is recommending:
1 - 4 ton unit & 1 - 3 ton unit
To salvage as much duct as we can
To figure best layout after demo
He told us to allow $25,000
MASONRY COSTS - $875.00
To brick in the first cubby hole for storage.  Still collecting bids.
Randy Trull
Materials - $450
Labor - $425
DROP CEILING COSTS - $11,951.10
COWTOWN MATERIALS
12' main beam (5ctn)

$1,278.00
12' wall angle (5 ctn)$1,236.00
4' cross tee (10ctn)$2,371.20
2x4 SE white panel (47ctn)$4,178.11
12' hanger wire (1 bdl)$99.95
R19 insulation (32 bags)$2,787.84
FLOORING COSTS - $24,750.00
YATES FLOORING
Carpet Squares = $4.50 / sqft.$20,250.00
Laminate = $3.50 / sqft.$15,750.00
Carpet Squares Labor$4,500.00
Laminate Labor$13,500.00

DO IT OURSELVES
Carpet squares = $3.00 / sqft$13,500.00
Vinyl Plank Flooring = $4.00 / sqft$18,000.00
MISCELLANEOUS COSTS - $10,000.00
It just seems like things always get more expensive than you expect.
LABOR COSTS - (Food, lots of food)
We're talking cakes, pies, the works!
Whatever it takes to keep our working men happy!
RUNNING TOTAL - $88,803.77
We are leaving the flooring bid from Yates, but understand that there are likely much cheaper options available.
